What the work is
A coated garage floor is three things in order: preparation, a base coat, and a clear coat over it. Almost everything that goes wrong goes wrong in the first one, and almost nobody quotes it in detail.
Concrete finishes with a weak, fines-rich film on top of it called laitance. It is part of how a slab is poured, not a defect. A coating rolled onto that film is bonded to the film, and when the film lets go the floor looks like it failed. Diamond grinding removes it and leaves a measurable profile for the resin to key into. That profile has a number on a published scale and you are entitled to ask which one we ground to and how we checked.
Then the slab is tested for moisture, the cracks and spalls are repaired as their own step, and only then does anything get applied. A crack that is still moving telegraphs back through a coating within a season, so it is repaired first or it is left alone and named on the quote.
We will tell you if your slab is a poor candidate. Some are. A slab reading high on moisture, or one that has been sealed repeatedly with something that will not come off, costs more to prepare than the finish is worth, and you should hear that from us before you have paid for anything.
What is included
- Moving what you can move; we say plainly what has to be out before the day
- Diamond grinding the full floor, with the edges and corners cut in by hand
- Dust extraction at the machine, so the grinding does not end up in the house
- Crack and spall repair as a named step, quoted before it is done
- A moisture test on the slab, with the reading written down for you

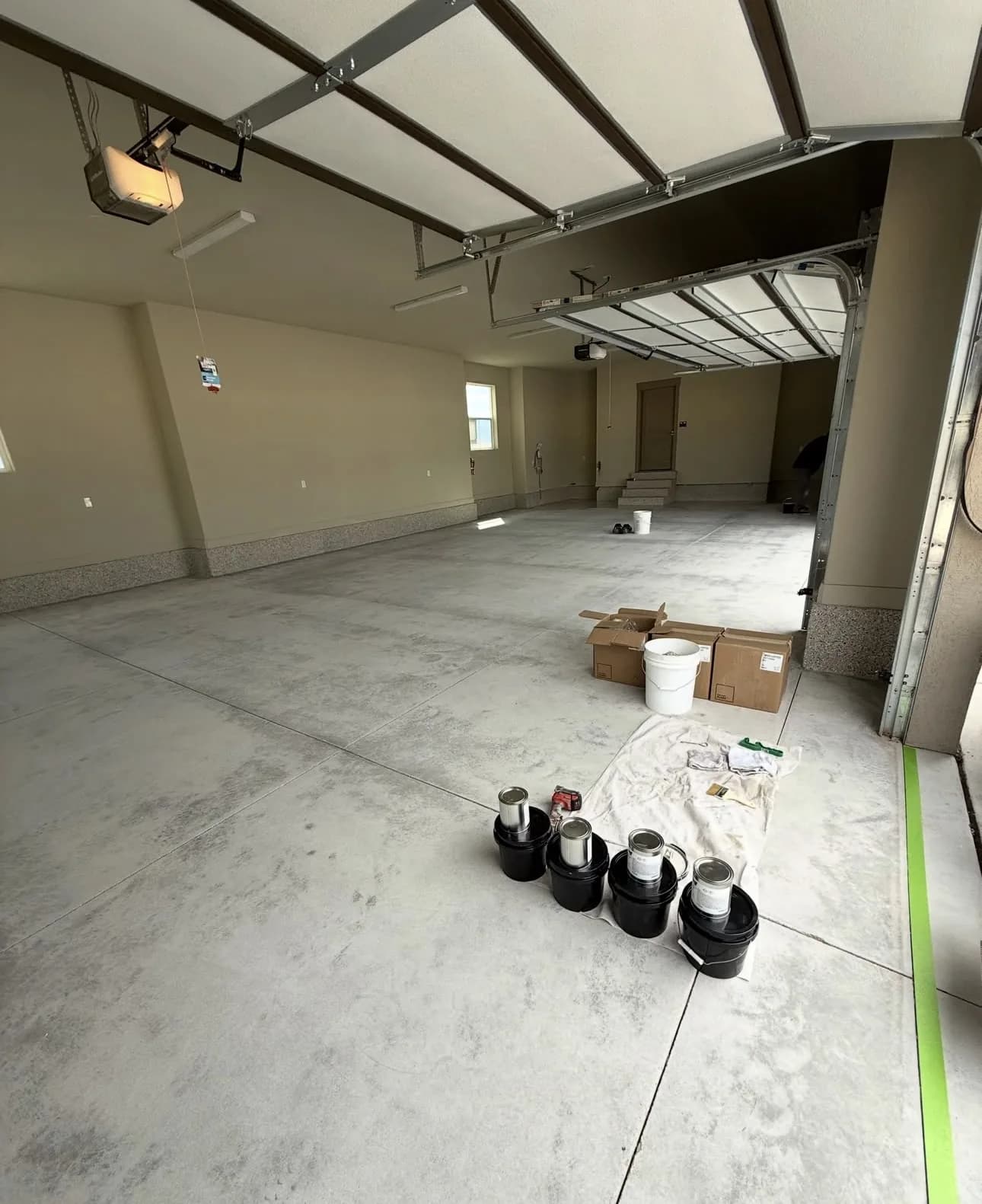

- Masking the walls, the door track and anything the coating could reach
- Base coat, the chosen finish, and the clear coat over it
What is not
- Emptying the garage. It has to be clear, and that is the part people underestimate
- Storing your belongings while the floor cures
- Structural repair of a slab that is heaving or settling. That is a different trade and we will say so
- Coating over an existing finish we cannot verify. It comes off first, or we do not quote it
- A date we cannot hold. Exterior aprons wait on weather; the inside of the bay does not
What is different about doing this here
St. George recorded 98 days at or above 100°F in 2024, the most on record, and the all-time high is 117°F. An attached garage here spends the summer hot. That matters twice: it is what the finished floor lives with, and it is a constraint on the work itself, because resin systems have a published application temperature window and their working time shortens as the slab warms.
The other local one is sand. The Utah Geological Survey maps wind-blown sand as one of nine adverse construction conditions for this area, and Washington County publishes it as its own hazard layer — most counties do not map blowing sand at all, which is the signal that it matters here. Wet resin holds whatever lands in it. That is a real reason the exterior half of a job gets scheduled around a wind forecast, and April is the windiest month.
What to ask anyone quoting this, us included
- How is the slab being prepared, and if the answer is grinding, to what surface profile?
- Which moisture test are you running, and can I see the reading?
- Which product is going on my floor, and can I see its data sheet?
- What happens to the cracks, and is that in the quote or added later?
- Who is preparing the slab, and are they the same people applying the finish?
